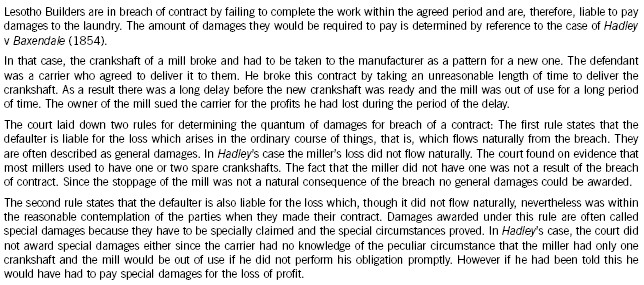

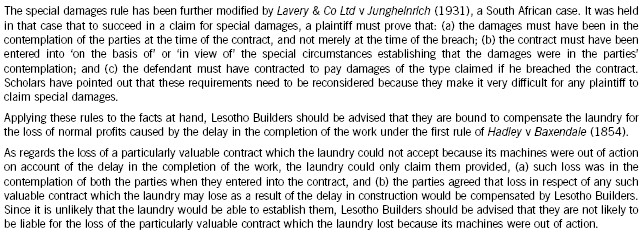

Lesotho Builders agreed to reconstruct a laundry and to complete the work within 10 weeks. The work took 12 weeks and the laundry is claiming damages for the loss of normal profits during the two additional weeks and also for the loss of a particularly valuable contract which it could not accept because its machines were out of action.Required:Advise Lesotho Builders as to their liability for breach of contract. (10 marks)
